Metro Is Not Metro for Every Corridor: Which Clusters Benefit, Which Don't

BangaloreSelect Research·2026-04-30·7 min read

BMRCL Phase 2B will reach parts of North Bangalore. Some clusters sit 2 km from a confirmed station. Others are 8–12 km away with no confirmed timeline. The metro story is real — it does not apply equally to every project that claims it.

Metro is not metro for every corridor — which clusters actually benefit

Metro Phase 2 will reach parts of North Bangalore. The operative word is "will." Some clusters sit 2–3 km from a confirmed station on an active construction alignment. Others are 8–12 km from the nearest planned station, with no confirmed timeline.

The metro story in North Bangalore is real. It does not apply equally to every project that claims it.

What Phase 2B actually covers

BMRCL's Blue Line Phase 2B extends from the current Silk Board terminus, runs through the Central Silk Board junction, and continues north to Kempegowda International Airport. The total alignment is 58.19 km. The target completion is mid-2027.

The northern segments relevant for residential clusters are the stations between Hebbal and the airport: Nagasandra (existing), Jakkur, Doddajala, Bagalur Cross, Airport City, KIAL Terminals, and the terminal station at KIA.

This alignment is confirmed. BMRCL has civil works contracts in place. The line is funded. The station positions are published.

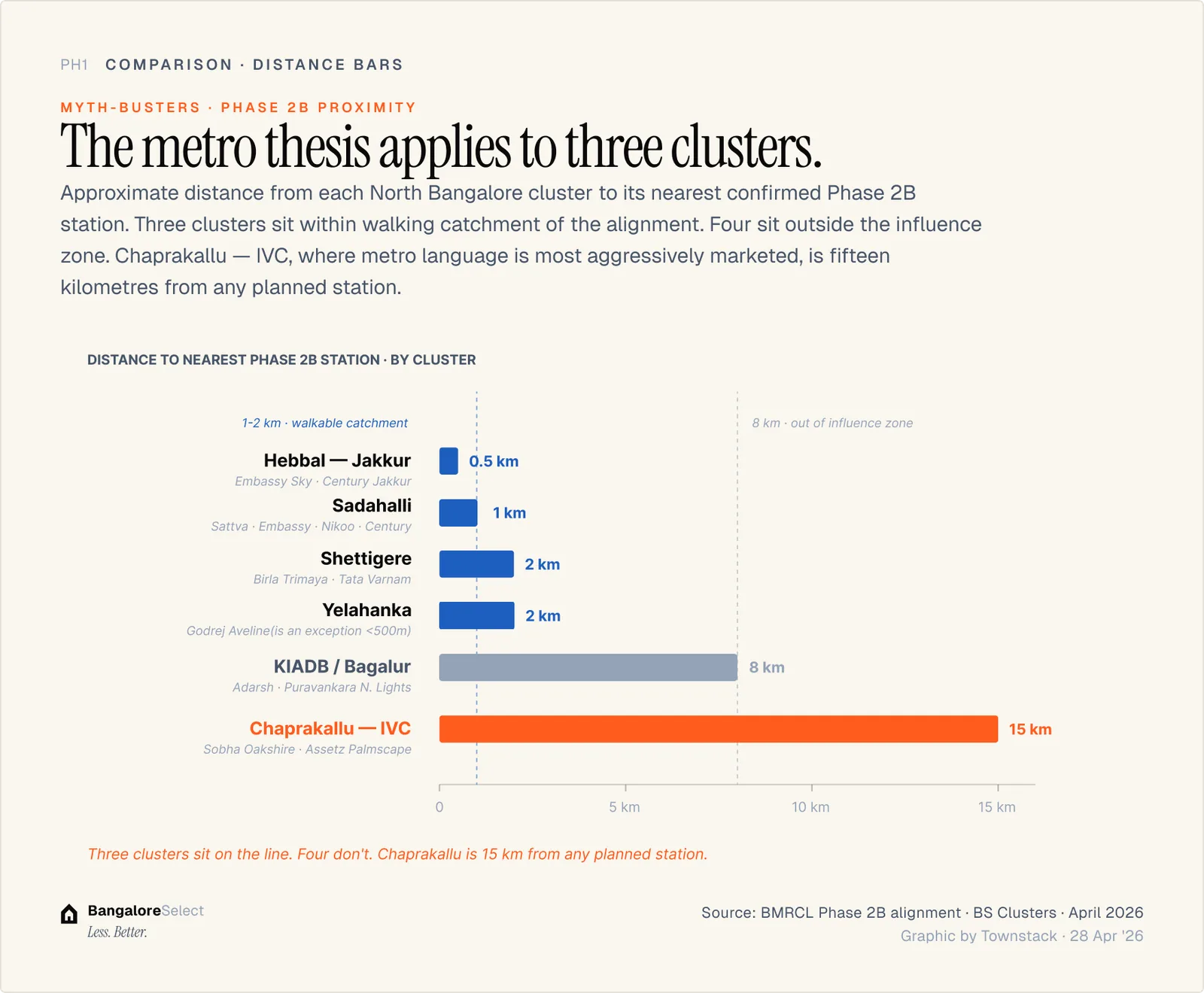

Phase 2B proximity map — confirmed station positions by cluster

What Phase 2B does not cover

The alignment follows a specific route. Clusters not on or adjacent to that route do not get a metro station. Phrases like "metro connectivity coming to North Bangalore," "well-connected to proposed metro lines," and "part of the metro influence zone" are marketing language that should be verified against the BMRCL published alignment before being treated as facts.

The clusters by their actual metro relationship:

Hebbal–Jakkur (CL-001): Metro connection exists today. The Green Line runs to Nagasandra, adjacent to this cluster. Embassy Sky Terraces and Century Jakkur are the active projects. These buyers already have metro access; Phase 2B adds the airport extension.

Yelahanka (CL-006): The Phase 2B alignment passes through the Yelahanka area en route from Hebbal to the airport. Godrej Aveline and Century Kindle are the active projects. Confirmed station proximity.

Shettigere (CL-005): The Phase 2B alignment runs through this corridor. Birla Trimaya and Tata Varnam are the active projects mapped to Phase 2B stations. This is the cluster where the metro-appreciation thesis is most directly applicable.

Sadahalli (CL-004): Sattva City, Century OneWorld-Seraya, Embassy Springs Verde, and Nikoo Gardenia Estate are active here. This cluster is near the airport terminus stations but not on the core residential alignment. Metro proximity applies at the airport end of the line.

Hennur–Thanisandra Road (CL-002): Not on the Blue Line Phase 2B alignment. The connectivity story here is ORR access and Manyata Tech Park proximity, not metro proximity. Metro claims for this cluster require verification.

KIADB/Bagalur (CL-003): No direct Phase 2B station on this alignment. KIADB's employment anchor is road-based, not metro-based.

Chaprakallu–IVC Road (CL-007): No metro line is planned for this corridor. The value thesis is road infrastructure — STRR and elevated corridors — not transit.

The 8-year horizon problem

The Blue Line Phase 2B target is mid-2027. If it slips, the realistic completion window stretches to 2028 or 2029.

A buyer entering a cluster in 2026 on a 3-year horizon is buying against a metro that may open 1–2 years into their hold period at best. The appreciation event they are pricing in may not fully materialise within their exit window.

A buyer with a 7–10 year horizon holds this risk more comfortably. The metro will open within that window. The question of which year matters less.

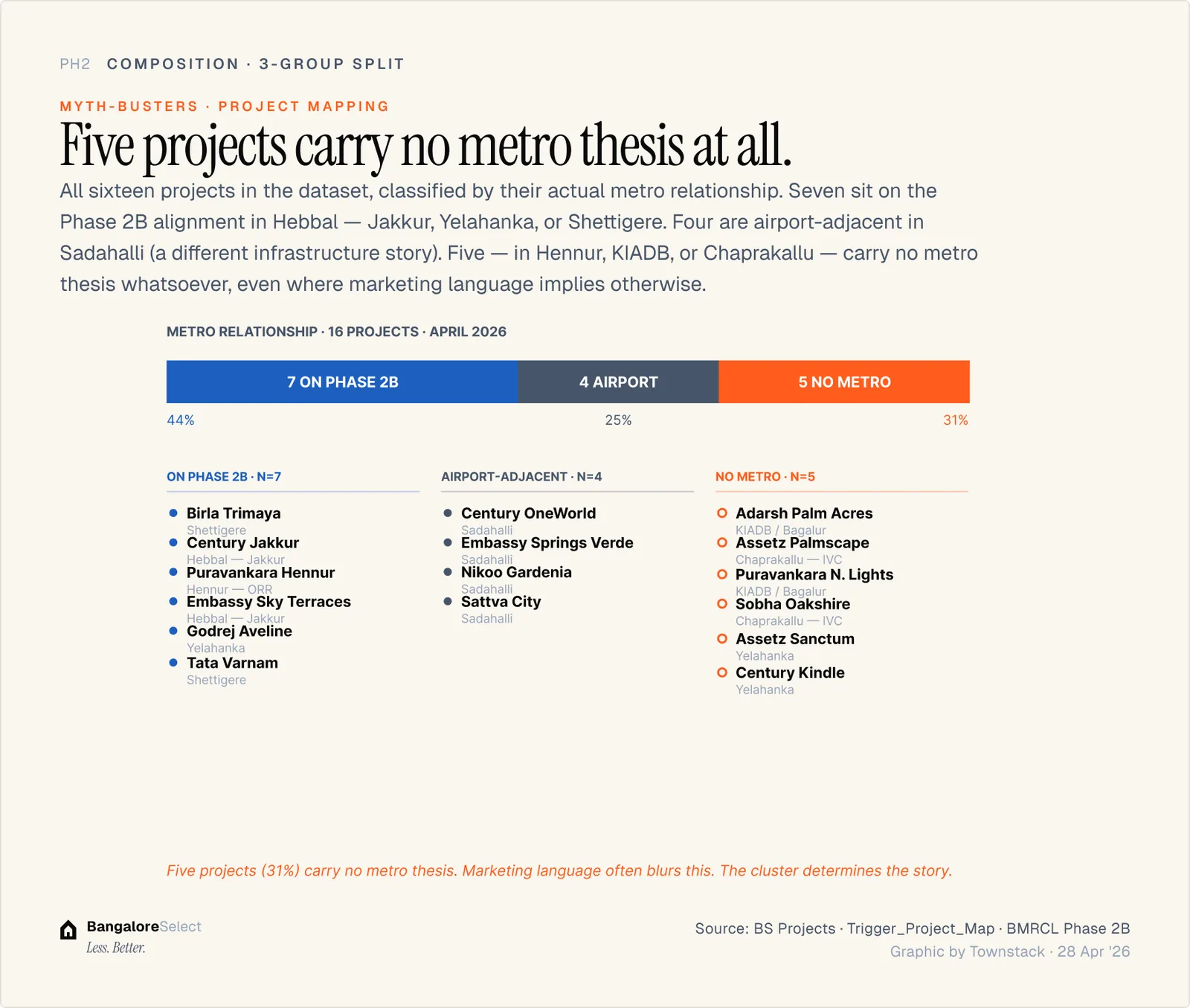

Projects by metro status — confirmed, adjacent, and claimed

The cluster test before buying on the metro thesis

Before accepting a developer's metro claim, run three checks.

Is the project within 2 km of a confirmed, named station on the Phase 2B alignment? BMRCL's published route maps show confirmed station positions. Distance from any named station should be verifiable on a map, not estimated from marketing materials.

Is Phase 2B the relevant line, or is the claim based on a proposed line in a different phase? Phase 3 and Phase 4 alignments exist in planning documents. They are not funded, not under construction, and have no confirmed timelines. A claim based on Phase 3 or 4 is a decade-plus speculation, not a near-term trigger.

What is the buyer's actual commute use case? Metro is most valuable to buyers who will use it for daily commuting to the Central Business District or to tech park hubs connected by existing metro. If the buyer's primary employment destination is a campus that is 20 km from any metro station, the metro proximity premium is reduced.

The metro is a real infrastructure event in North Bangalore. It is concentrated on a specific alignment, not distributed across the entire region. Verify before pricing.
